Modular Building Solutions: Fast, Scalable, Sustainable

2025 . 10. 26

Why Modular Building Solutions are rewriting the project playbook

I’ve spent enough time around dusty job sites to know: schedules slip, budgets groan, and neighbors complain. Then along came the assemble container house from Suzhou—quietly pragmatic, surprisingly refined—and the calculus started to change. In the last two years, Modular Building Solutions moved from “interesting” to “inevitable,” especially for teams juggling speed, quality, and carbon targets.

Modular Building Solutions: Fast, Scalable, Sustainable

What it is (and what it isn’t)

The assemble container house is a steel-framed, panelized module built in a controlled factory environment in Fanxiang Village, Taoyuan Town, Wujiang District, Suzhou City, China. Think plug-and-play shells that arrive flat or volumetric, then bolt together on site. It’s not a compromise box; it’s a system. Many customers say the shocker is the finish quality—doors swing true, wiring lands exactly where the drawings said it would. To be honest, that’s the factory advantage.

Quick spec snapshot

Parameter Typical Spec (≈) Notes
Module size 20 ft / 40 ft; 13.8–28.8 m² internal Custom footprints available
Frame Galvanized Q235B/Q345B, 2.5–3.5 mm EN 1090 / GB 50205 shop-fab practices
Walls/Roof EPS/PU/Rockwool 50–100 mm Up to EN 13501 B-s1,d0 with rockwool
Thermal U ≈ 0.28–0.45 W/m²·K Real-world use may vary by climate
Wind/Snow 0.6–0.8 kPa / 0.75–1.5 kN/m² Project-specific engineering
Fire & MEP ASTM E84 class A; IEC 60364 wiring Local code alignment required
Assembly 4–6 hours per module, 4 workers Crane or telehandler needed
Service life ≈ 15–25 years With scheduled maintenance

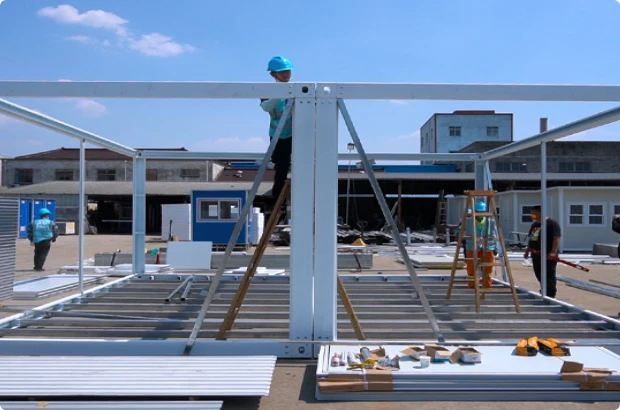

Process flow that actually works

Materials: galvanized structural steel, MgO subfloor, sandwich panels, PVC finish, IEC-grade cabling. Methods: CNC cutting, MIG welding, hot-dip galvanizing or powder coat, pre-fit MEP, and water testing. QA: weld MT/UT per ISO 17638/17640, air/water tests per ASTM E283/E331, insulation checks, and electrical tests per IEC 60364. Factory QMS under ISO 9001 helps—less rework, fewer site surprises. Service life is mostly about coatings and seals; re-caulk every 3–5 years and you’re fine.

Modular Building Solutions: Fast, Scalable, Sustainable

Where teams deploy it

Rapid workforce housing, schools and clinics, site offices, retail pop-ups, emergency shelters, even boutique hospitality. One GC told me, “Honestly, the schedule win paid for itself.” That rings true: Modular Building Solutions shift 60–80% of work off-site, cutting noise and neighborhood friction.

Vendor snapshot (real-world, not hype)

Vendor Lead time Customization Certs Price ≈ (USD/m²) Notes
ZN House (Suzhou) 2–4 weeks High (layouts, cladding, HVAC) ISO 9001; component CE ≈ 280–420 Strong export know-how
Regional Prefab B 6–10 weeks Medium Local code stamps ≈ 350–550 Permitting support
Global Modular C 8–12 weeks High ICC/IBC familiarity ≈ 500–800 Broader compliance set

Indicative figures only; design, logistics, and local codes will nudge numbers up or down.

Customization and integration

Facade choices (metal, fiber-cement, wood-look), low-e glazing, split or VRF HVAC, PV-ready roofs, low-VOC interiors, ADA/accessible modules, and BIM models (IFC/Revit) for clash-free coordination. For sustainability goals, ask for EPD data and embodied carbon estimates; some teams are hitting 30–50% schedule compression with 10–20% waste reduction.

Two quick case notes

- Coastal site office, 12 modules: installed in three days; blower-door test hit ≈ 3.5 ACH@50Pa; PM said, “Fewer RFIs than any site build.”
- Rural clinic, 6 modules: rockwool panels for fire and acoustic control; nurse lead told me patients “thought it was a permanent build”—which, frankly, it is.

Standards to check (and cite)

For compliance, align factory output with ICC off-site standards, ASTM fire/air-water tests, and local IBC adoption. If you’re spec’ing internationally, lock electrical to IEC early and confirm seismic/wind with a local engineer. It seems obvious, but I’ve seen that step save weeks.

Authoritative citations

  1. ICC 1200/1205 Off-Site Construction Standards
  2. ASTM E84 Surface Burning Characteristics
  3. ISO 9001: Quality management systems
  4. International Building Code (IBC) 2021
  5. ASTM E331 Water Penetration of Exterior Walls
  6. IEC 60364 Low-voltage electrical installations
